![]() | Valaris Limited Fleet Status Report May 4, 2026 | |||||||||||||
| New Contracts, Extensions and Other Updates Since Last Fleet Status Report | ||||||||
Contract Backlog •Valaris has been awarded the following new contracts and contract extensions, with associated contract backlog of approximately $560 million, subsequent to issuing its previous fleet status report on February 17, 2026. Contract backlog excludes lump sum payments such as mobilization fees and capital reimbursements. •Contract backlog increased to approximately $4.9 billion from approximately $4.7 billion as of February 17, 2026. Floater Contract Awards •1,064-day contract extension for drillship VALARIS DS-4 with Petrobras offshore Brazil. The extension is expected to commence in November 2027 in direct continuation of the existing program and will add approximately $447 million to contract backlog. In conjunction with the extension, the day rate for the remainder of the existing contract has been adjusted, reducing contract backlog from April 1, 2026 to November 2027 by approximately $21 million. Jackup Contract Awards •Two-year contract extension for jackup VALARIS 115 with Brunei Shell Petroleum. The contract extension is expected to commence in April 2027 in direct continuation of the existing program and will add approximately $78 million to contracted revenue backlog. •One-well contract for jackup VALARIS 106 with Medco Energi offshore Indonesia. The contract commenced in April 2026 and has a minimum duration of 45 days. The estimated total contract value is approximately $5.4 million. •123-day contract extension for jackup VALARIS 122 with Adura in the UK North Sea to provide accommodation support services. The contract extension commenced in May 2026 in direct continuation of the existing program and will add approximately $14 million to contracted revenue backlog. •Two-well contract for jackup VALARIS 122 with INEOS in the UK North Sea. The contract is expected to commence in September 2026 and has an estimated duration of 162 days. The operating day rate is $115,000. The contract also includes options with an estimated total duration of 825 days for work in the UK and Danish North Sea. •123-day contract extension for jackup VALARIS 123 with TAQA in the Dutch North Sea to provide accommodation support services. The contract extension commenced in May 2026 in direct continuation of the existing program. The day rate is $80,000. | Jackup Contract Awards (continued) •74-day contract extension for jackup VALARIS 248 with GE Vernova in the UK North Sea to provide accommodation support services for an offshore wind project. The contract extension commenced in April 2026 in direct continuation of the existing program and will add over $5 million to contracted revenue backlog. Middle East Operations Update •All Valaris and ARO rigs operating in the Middle East remain under contract. •Completion of planned shipyard projects for VALARIS 116 and 250 have been delayed, with bareboat charters for the rigs now expected to resume in the third quarter 2026. •Operations for VALARIS 110 have been suspended since early March 2026; the rig remains contracted to NOC offshore Qatar. Other Fleet Status Updates •Semisubmersible VALARIS DPS-1 sold for recycling in April 2026. | |||||||
![]() | Valaris Limited Fleet Status Report May 4, 2026 | |||||||||||||
Contract Backlog(1) (2) ($ millions) | 2026 | 2027 | 2028+ | Total | Contracted Days(1) (2) | 2026 | 2027 | 2028+ | |||||||||||||||||||||
| Drillships | $ | 863.8 | $ | 1,279.6 | $ | 1,176.4 | $ | 3,319.8 | Drillships | 2,051 | 2,953 | 2,819 | |||||||||||||||||
| Semisubmersibles | — | — | — | — | Semisubmersibles | — | — | — | |||||||||||||||||||||
| Floaters | $ | 863.8 | $ | 1,279.6 | $ | 1,176.4 | $ | 3,319.8 | Floaters | 2,051 | 2,953 | 2,819 | |||||||||||||||||
| Harsh Environment | $ | 181.1 | $ | 131.8 | $ | 37.2 | $ | 350.1 | Harsh Environment | 1,491 | 974 | 316 | |||||||||||||||||
| Benign Environment | 209.2 | 286.0 | 192.0 | 687.2 | Benign Environment | 1,540 | 2,217 | 1,812 | |||||||||||||||||||||
| Legacy | 48.2 | 50.1 | — | 98.3 | Legacy | 484 | 505 | — | |||||||||||||||||||||
| Jackups | $ | 438.5 | $ | 467.9 | $ | 229.2 | $ | 1,135.6 | Jackups | 3,515 | 3,696 | 2,128 | |||||||||||||||||
Other(3) | $ | 118.6 | $ | 109.1 | $ | 246.0 | $ | 473.7 | Other(3) | 1,908 | 2,315 | 5,422 | |||||||||||||||||
| Total | $ | 1,420.9 | $ | 1,856.6 | $ | 1,651.6 | $ | 4,929.1 | Total | 7,474 | 8,964 | 10,369 | |||||||||||||||||
ARO Drilling(4) | Average Day Rates(1) (2) | 2026 | 2027 | 2028+ | |||||||||||||||||||||||||
| Owned Rigs | $ | 146.2 | $ | 115.5 | $ | 491.4 | $ | 753.1 | Drillships | $ | 421,000 | $ | 433,000 | $ | 417,000 | ||||||||||||||
| Leased Rigs | 174.2 | 291.8 | 697.6 | 1,163.6 | Semisubmersibles | — | — | — | |||||||||||||||||||||
| Total | $ | 320.4 | $ | 407.3 | $ | 1,189.0 | $ | 1,916.7 | Floaters | $ | 421,000 | $ | 433,000 | $ | 417,000 | ||||||||||||||
| Harsh Environment | $ | 121,000 | $ | 135,000 | $ | 118,000 | |||||||||||||||||||||||
| Benign Environment | 136,000 | 129,000 | 106,000 | ||||||||||||||||||||||||||
| Legacy | 100,000 | 99,000 | — | ||||||||||||||||||||||||||
| Jackups | $ | 125,000 | $ | 127,000 | $ | 108,000 | |||||||||||||||||||||||
(1) Contract backlog, contracted days and average day rates as of May 4, 2026. (2) Contract backlog and average day rates exclude certain types of non-recurring revenues such as lump sum mobilization payments. Contract backlog and contracted days may include backlog and days when a rig is under suspension, except any backlog or days for rigs that are under a separate firm contract where backlog or days are otherwise included. Average day rates are adjusted to exclude suspension backlog and days. (3) Other represents contract backlog and contracted days related to bareboat charter agreements and management services contracts. (4) ARO Drilling contract backlog as of May 4, 2026. | |||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report May 4, 2026 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Drillships | ||||||||||||||||||||||||||||||||||||||||||||||||||

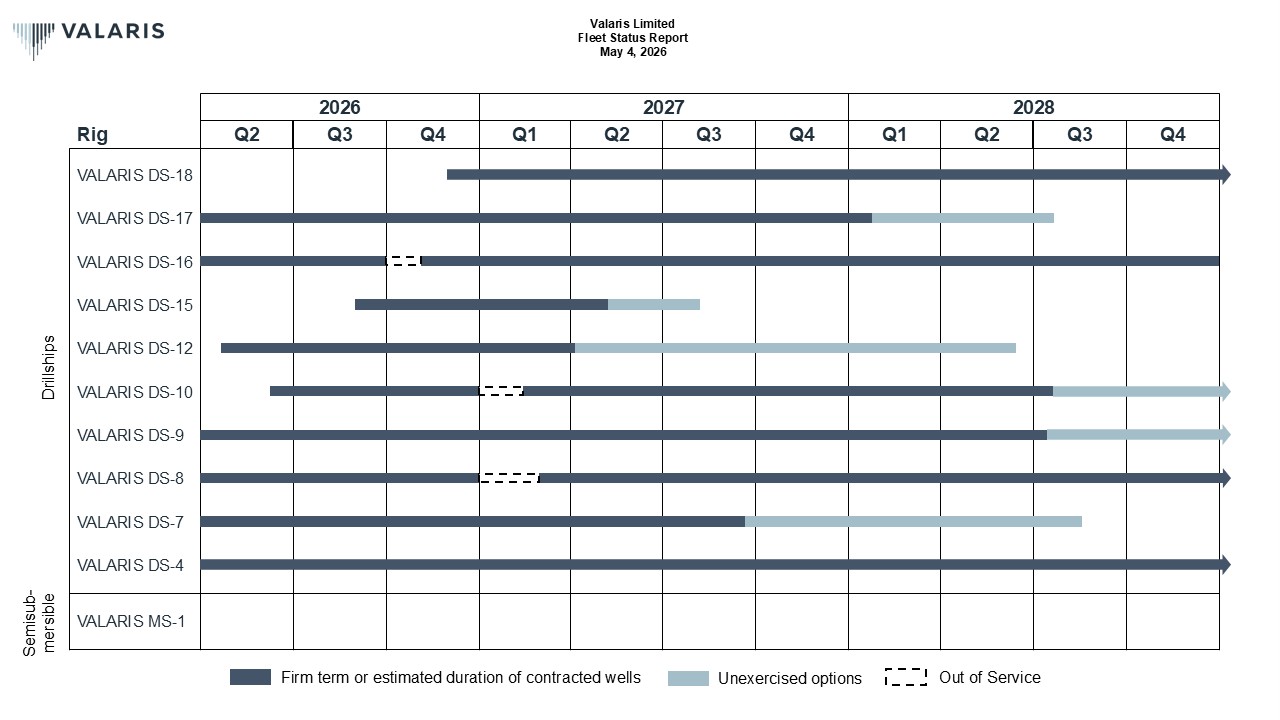

| VALARIS DS-18 | GustoMSC P10000 | 2015 | Occidental | Gulf of America | Dec 26 | Jun 29 | 914-day contract for DS-18 and 940-day contract extension for DS-16. Combined addition to contracted revenue backlog is approx. $760 million. Two 1-year options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-17 | GustoMSC P10000 | 2014 | Equinor | Brazil | Mar 26 | Jan 28 | Estimated total contract value ("TCV") of $498 million, inclusive of MPD, additional services and fees for mobilization and minor rig upgrades. Based on initial estimated duration of 852 days comprised of a 180-day standby period and a 672-day drilling program. Two 90-day priced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-16 | GustoMSC P10000 | 2014 | Occidental Occidental | Gulf of America Gulf of America | Jun 24 Jun 26 | Jun 26 Dec 28 | Additional rate charged when MPD services provided 940-day contract extension for DS-16 and 914-day contract for DS-18. Combined addition to contracted revenue backlog is approx. $760 million. Two 1-year options. Expect approx. 35 days out of service for planned maintenance in 4Q26 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-15 | GustoMSC P10000 | 2014 | CNR | Spain Cote d'Ivoire | Sep 26 | May 27 | Rig is warm stacked in Las Palmas, Spain TCV, based on an estimated duration of 250 days, is approx. $135 million, including upfront payments for rig upgrades and mobilization. TCV does not include the provision of additional services. Priced options with a total estimated duration of 80 to 100 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-12 | DSME 12000 | 2013 | BP | Egypt | Apr 26 | Apr 27 | TCV, based on estimated duration of 350 days, is approx. $140 million, inclusive of MPD and mobilization. Three option wells | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-10 | Samsung GF12000 | 2017 | Shell | Spain Nigeria | Jun 26 | Jul 28 | Rig is warm stacked in Las Palmas, Spain TCV of $352 million based on duration of two years. TCV does not include the provision of additional services. Additional rate charged when CML services provided. Two 1-year options. Expect approx. 45 days out of service for rig upgrades in 1Q27 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-9 | Samsung GF12000 | 2015 | ExxonMobil ExxonMobil | Angola Angola | Jul 22 Jul 26 | Jul 26 Jul 28 | Contract includes MPD services Operating day rate is in line with recent market rates in the region. Two 6-month options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-8 | Samsung GF12000 | 2015 | Petrobras Shell | Brazil Brazil | Dec 23 Mar 27 | Dec 26 May 29 | $428,000 | Plus mobilization fee of approx. $30 million. Contract includes additional services. Expect approx. 60 days out of service for rig upgrades in 1Q27 TCV of approx. $300 million, excluding additional services, based on estimated duration of 800 days. Options with a total estimated duration of approx. one year | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-7 | Samsung 96K | 2013 | Azule Energy Azule Energy | Angola Angola | Jun 24 Oct 26 | Oct 26 Sep 27 | TCV estimated to be $364 million based on initial estimated duration of 850 days Contract backlog of approx. $125 million based on estimated duration of 325 days. Five-well unpriced option with an estimated duration of 300 to 350 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-4 | Samsung 96K | 2010 | Petrobras Petrobras | Brazil Brazil | Dec 24 Nov 27 | Nov 27 Oct 30 | Previous day rate of $450,000 has been adjusted, reducing contract backlog from Apr 2026 to Nov 2027 by approx. $21 million. Plus mobilization fee of approx. $41 million. Contract includes MPD and additional services. Contracted revenue backlog of approx. $447 million for 1,064-day extension | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-14 | DSME 12000 | 2023 | Spain | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-13 | DSME 12000 | 2023 | Spain | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-11 | DSME 12000 | 2013 | Spain | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report May 4, 2026 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Semisubmersibles | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS MS-1 | F&G ExD Millennium, Moored | 2011 | Malaysia | Warm stacked | ||||||||||||||||||||||||||||||||||||||||||||||
| Sold | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DPS-1 | F&G ExD Millennium, DP | 2012 | Malaysia | Rig sold for recycling in April 2026 | ||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report May 4, 2026 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Harsh Environment Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||

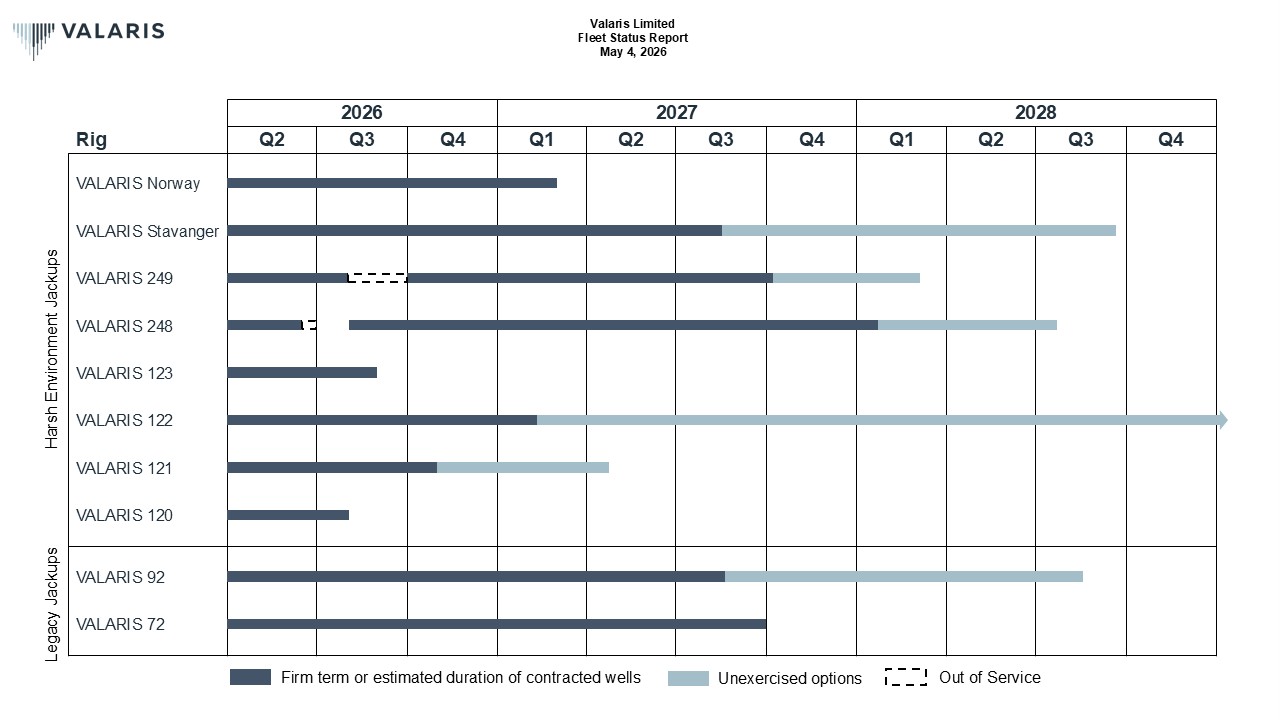

| VALARIS Norway | KFELS N Class | 2011 | Ithaca Energy Ithaca Energy | UK UK | Apr 25 May 26 | May 26 Feb 27 | TCV of approx. $39 million based on estimated duration of 292 days Contracted revenue backlog of approx. $36 million based on duration of 300 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS Stavanger | KFELS N Class | 2011 | TotalEnergies | UK | Jan 26 | Aug 27 | TCV of over $75 million based on 600-day priced extension. Two 200-day priced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 249 | LT Super Gorilla | 2001 | Undisclosed BP Shell | Trinidad Trinidad Trinidad | Apr 25 Apr 26 Oct 26 | Mar 26 Aug 26 Oct 27 | $163,000 | TCV of $16.8 million based on duration of 100 days. Expect approx. 60 days out of service for planned maintenance in 3Q26 Contracted revenue backlog of approx. $66 million based on estimated duration of 365 days. Three priced options with an estimated duration of 50 days each | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 248 | LT Super Gorilla | 2000 | GE Vernova Eni | UK UK | Nov 25 Aug 26 | Jun 26 Jan 28 | Contracted revenue backlog of approx. $16 million for 224-day contract to provide accommodation support services. Expect approx 15 days out of service for planned maintenance in 2Q26 TCV of approx. $84 million for 730-day contract to perform P&A and CCS work. Two 3-month options. VALARIS 120 will substitute for VALARIS 248 while the rig completes another customer's program and a special periodic survey | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 123 | KFELS Super A | 2019 | TAQA TAQA | Netherlands Netherlands | Jan 26 Jan 26 | Jan 26 Aug 26 | $163,000 $80,000 | Accommodation support | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 122 | KFELS Super A | 2014 | Adura INEOS | UK UK | Jan 26 Sep 26 | Aug 26 Feb 27 | $115,000 | Contracted revenue backlog of approx. $28 million for extensions totaling 243 days. The extensions are for accommodation support Options with an estimated total duration of 825 days for work in the UK and Danish North Sea | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 121 | KFELS Super A | 2014 | Adura Adura | UK UK | Jan 25 Feb 26 | Jan 26 Oct 26 | TCV of approx. $55 million based on estimated duration of 406 days Contracted revenue backlog of over $25 million based on estimated duration of 194 days. Option with an estimated duration of 150 to 200 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 120 | KFELS Super A | 2013 | Eni | UK | Jan 26 | Aug 26 | VALARIS 120 will substitute for VALARIS 248 from Jan 2026 to Aug 2026, while VALARIS 248 completes another customer's program and a special periodic survey | |||||||||||||||||||||||||||||||||||||||||||
| FLEET AWARD | Spirit Energy | UK | Commencement window up to Dec 2030; estimated duration of 294 days. Contracted revenue backlog of $35 million, subject to an annual cost escalation mechanism effective from the contract execution date. Three options with a total estimated duration of 426 days. Fleet award under which operations may be performed by any suitable and available rig within the Valaris North Sea Fleet | |||||||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS Viking | KFELS N Class | 2010 | UK | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report May 4, 2026 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Benign Environment Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||

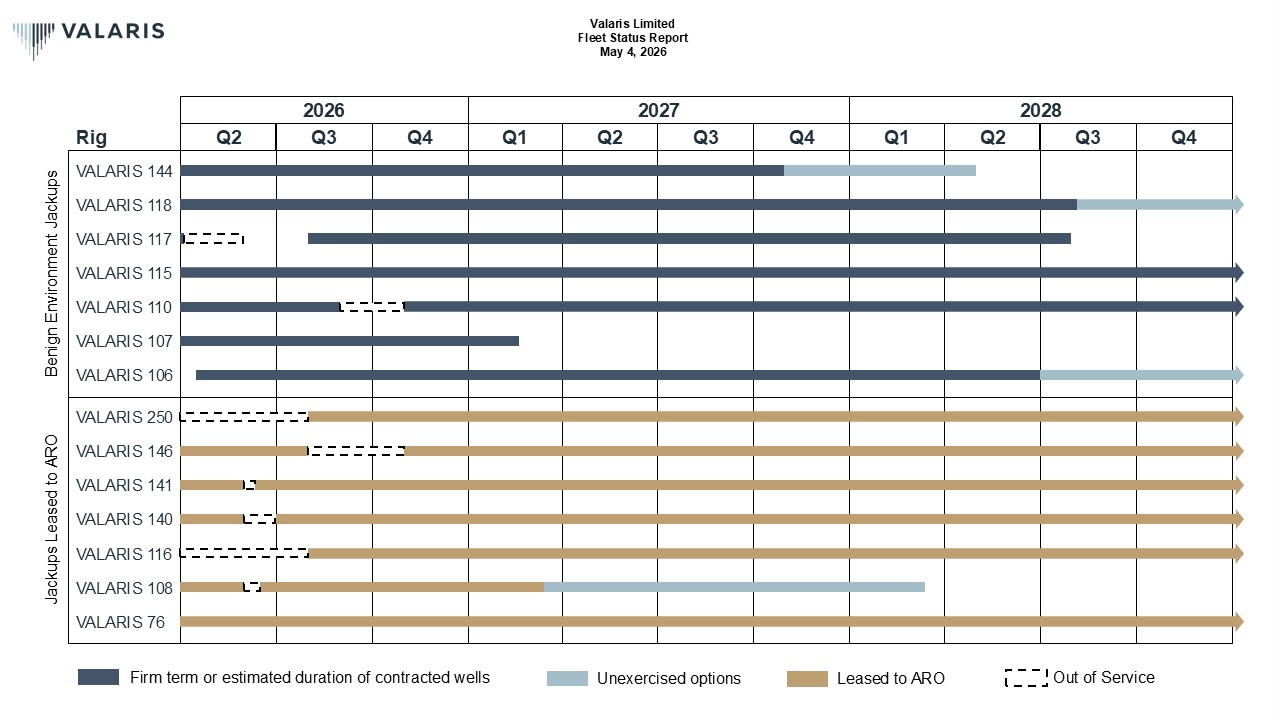

| VALARIS 144 | LT Super 116-E | 2010 | Azule Energy | Angola | Sep 25 | Oct 27 | TCV estimated to be between $149 million and $156 million based on contract duration of 730 to 770 days, including a mobilization fee from the Gulf of America. Three-well option | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 118 | LT 240-C | 2012 | BP | Trinidad | Nov 25 | Aug 28 | TCV of approx. $168 million based on duration of three years. Two 1-year options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 117 | LT 240-C | 2009 | Eni Undisclosed | Mexico Trinidad | Apr 25 Aug 26 | Apr 26 Aug 28 | TCV of approx. $36 million based on duration of 300 days. Expect approx. 60 days out of service for planned maintenance in 2Q26 Day rate in line with market rates in the region | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 115 | BM Pacific Class 400 | 2013 | Shell Shell | Brunei Brunei | Apr 23 Apr 27 | Apr 27 Apr 29 | TCV of approx. $159 million based on duration of four years Contracted revenue backlog of approx. $78 million for two-year extension | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 110 | KFELS MOD V-B | 2015 | NOC | Qatar | Oct 25 | Oct 29 | Contracted revenue backlog for the four-year extension is approx. $117 million. 1-year priced option. Expect approx. 60 days out of service for planned maintenance in 3Q/4Q26. Operations suspended since early March 2026 due to conflicts in the Middle East | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 107 | KFELS MOD V-B | 2006 | ExxonMobil GB Energy | Australia Australia | Nov 25 Nov 26 | Oct 26 Mar 27 | $163,000 | TCV of approx. $27 million based on estimated duration of 150 days | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 106 | KFELS MOD V-B | 2005 | BP Medco Energi BP | Indonesia Indonesia Indonesia | Jun 25 Apr 26 Jul 26 | Jan 26 Jun 26 Jun 28 | $95,000 | TCV of $5.4 million based on minimum duration of 45 days Expect out of service time for leg repairs in 2Q26; duration to be determined upon rig's arrival at shipyard in Singapore TCV of approx. $74 million based on estimated duration of two years. Four 1-well options | ||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 148 | LT Super 116-E | 2013 | UAE | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 147 | LT Super 116-E | 2013 | UAE | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 143 | LT Super 116-E | 2010 | UAE | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 111 | KFELS MOD V-B | 2003 | Croatia | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 109 | KFELS MOD V-Super B | 2008 | Namibia | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 104 | KFELS MOD V-B | 2002 | UAE | |||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report May 4, 2026 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
| Legacy Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 92 | LT 116-C | 1982 | Shell | UK | Aug 25 | Aug 27 | Options with total duration of up to one year | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 72 | Hitachi 300C | 1981 | Eni | UK | Oct 25 | Sep 27 | ||||||||||||||||||||||||||||||||||||||||||||
Other - Jackups Leased to ARO Drilling(3) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 250 | LT Super Gorilla XL | 2003 | ARO Drilling | Saudi Arabia | May 25 | Apr 30 | Expect approx. 120 days out of service for planned maintenance in 2Q/3Q26. Completion of planned shipyard projects delayed due to disruptions related to conflicts in the Middle East; rig expected to resume bareboat charter in 3Q26 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 146 | LT Super 116-E | 2011 | ARO Drilling | Saudi Arabia | May 25 | Apr 30 | Expect approx. 90 days out of service for planned maintenance in 3Q/4Q26 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 141 | LT Super 116-E | 2016 | ARO Drilling | Saudi Arabia | Aug 25 | Aug 30 | Expect approx. 10 days out of service for planned maintenance in 2Q26 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 140 | LT Super 116-E | 2016 | ARO Drilling | Saudi Arabia | May 25 | Apr 30 | Expect approx. 30 days out of service for planned maintenance in 2Q26 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 116 | LT 240-C | 2008 | ARO Drilling | Saudi Arabia | May 25 | Apr 30 | Expect approx. 120 days out of service for planned maintenance in 2Q/3Q26. Completion of planned shipyard projects delayed due to disruptions related to conflicts in the Middle East; rig expected to resume bareboat charter in 3Q26 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 108 | KFELS MOD V-B | 2007 | ARO Drilling | Saudi Arabia | Mar 24 | Mar 27 | Expect approx. 15 days out of service for planned maintenance in 2Q26. 1-year priced option | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 76 | LT Super 116-C | 2000 | ARO Drilling | Saudi Arabia | Dec 25 | Dec 30 | Priced options of up to two years | |||||||||||||||||||||||||||||||||||||||||||
| Other - Managed Rigs | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Thunder Horse | Deepwater Semisubmersible | BP | Gulf of America | Jan 24 | Jan 27 | TCV of approx. $153 million | ||||||||||||||||||||||||||||||||||||||||||||
| Mad Dog | Deepwater Spar Drilling Rig | BP | Gulf of America | Jan 24 | Jan 27 | TCV of approx. $106 million | ||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report May 4, 2026 | |||||||||||||
| Asset Category / Rig | Design | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | |||||||||||||||||||||||||||||||||||||
| ARO Drilling | ||||||||||||||||||||||||||||||||||||||||||||
| Jackup Rigs Owned by ARO Drilling | ||||||||||||||||||||||||||||||||||||||||||||
| Gilbert Rowe | LT 116-C | Saudi Aramco | Saudi Arabia | Oct 17 | Jun 26 | Expect approx. 30 days out of service for planned maintenance in 3Q26 | ||||||||||||||||||||||||||||||||||||||
| SAR 201 | BM 200-H | Saudi Aramco | Saudi Arabia | Feb 18 | Jun 26 | Expect approx. 30 days out of service for planned maintenance in 3Q26 | ||||||||||||||||||||||||||||||||||||||
| Bob Keller | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 17 | Jun 26 | Expect approx. 30 days out of service for planned maintenance in 3Q26 | ||||||||||||||||||||||||||||||||||||||
| J.P. Bussell | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 17 | Jun 26 | |||||||||||||||||||||||||||||||||||||||
| Scooter Yeargain | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 26 | Expect approx. 85 days out of service for planned maintenance in 2Q26 | ||||||||||||||||||||||||||||||||||||||
| Hank Boswell | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 26 | |||||||||||||||||||||||||||||||||||||||
| SAR 202 | KFELS Super B | Saudi Aramco | Saudi Arabia | Oct 17 | Jun 26 | Expect approx. 15 days out of service for planned maintenance in 3Q26 | ||||||||||||||||||||||||||||||||||||||
| Kingdom 1 | LT 116-C | Saudi Aramco | Saudi Arabia | Nov 23 | Nov 31 | Expect approx. 30 days out of service for planned maintenance in 3Q26 | ||||||||||||||||||||||||||||||||||||||
| Kingdom 2 | LT 116-C | Saudi Aramco | Saudi Arabia | Aug 24 | Aug 32 | Expect approx. 25 days out of service for planned maintenance in 4Q26 | ||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report May 4, 2026 | |||||||||||||
Out of Service Days (1) | ||||||||||||||||||||||||||||||||
| Rig | Segment / Asset Category | Q2 2026 | Q3 2026 | Q4 2026 | Q1 2027 | |||||||||||||||||||||||||||
| VALARIS DS-16 | Floater - Drillship | 35 | ||||||||||||||||||||||||||||||
| VALARIS DS-10 | Floater - Drillship | 45 | ||||||||||||||||||||||||||||||
| VALARIS DS-8 | Floater - Drillship | 60 | ||||||||||||||||||||||||||||||
| VALARIS 249 | Jackup - Harsh Environment | 60 | ||||||||||||||||||||||||||||||
| VALARIS 248 | Jackup - Harsh Environment | 15 | ||||||||||||||||||||||||||||||
| VALARIS 117 | Jackup - Benign Environment | 60 | ||||||||||||||||||||||||||||||
| VALARIS 110 | Jackup - Benign Environment | 30 | 30 | |||||||||||||||||||||||||||||
| VALARIS 250 | Other - Jackups Leased to ARO Drilling | 90 | 30 | |||||||||||||||||||||||||||||
| VALARIS 146 | Other - Jackups Leased to ARO Drilling | 60 | 30 | |||||||||||||||||||||||||||||
| VALARIS 141 | Other - Jackups Leased to ARO Drilling | 10 | ||||||||||||||||||||||||||||||
| VALARIS 140 | Other - Jackups Leased to ARO Drilling | 30 | ||||||||||||||||||||||||||||||
| VALARIS 116 | Other - Jackups Leased to ARO Drilling | 90 | 30 | |||||||||||||||||||||||||||||
| VALARIS 108 | Other - Jackups Leased to ARO Drilling | 15 | ||||||||||||||||||||||||||||||
